HOVELL STREET UPGRADE PROJECT – COOTAMUNDRA

HOVELL STREET UPGRADE

  • Stage 1 involving the full road reconstruction between Sutton St and Hovell St has been completed.
  • Stage 2 – Eastbound has been completed, with new road pavement and kerb and guttering installed.
  • Stage 3 – Westbound involves the full road reconstruction between Campbell St and Cowcumbla St expected completion 30 June 2025. Access to Mitre 10 is availabe via the timber yard gateway. All traffic to use eastbound lane. Left turn only exiting residences & businesses in the work zone.
  • LOCAL TRAFFIC ONLY DURING WORKS includes residents and local businesses customers.
  • MOTORISTS ARE REQUESTED TO AVOID THE AREA IF POSSIBLE.

Work is being carried out by Council staff and fully funded by the NSW Government under the Fixing Local Roads Round 4 program at a cost of $1,804,120

“Please ensure all traffic signs, directions and traffic controllers are obeyed. Slow Down and be alert for workers and machinery.

Week commencing Monday 12/05 – Friday 23/05:

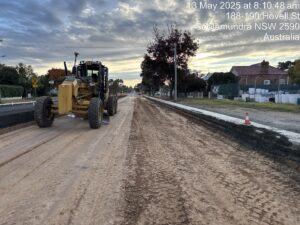

  • Pavement Removal Westbound (South Lane near rail line) to be completed. (Please note: Mitre 10 is open throughout the construction).

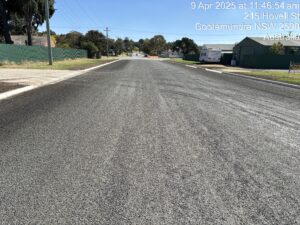

  • Pavement replacement completed.

Week commencingMonday 9/06 – Friday 13/06:

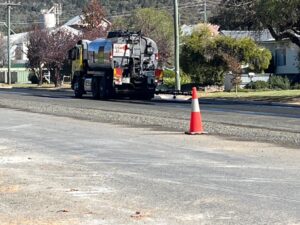

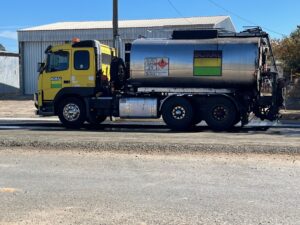

  • Asphalt surface installed. Limited access residential traffic only 24 hours after installation.
  • Project completion

Stage 2 Completed.

Stage 1 Completed.

For more information scroll down

THE HEAVY WORK TO CONTINUE ON HOVELL STREET

The commencement of major heavy road works on Cootamundra’s heavy vehicle bypass, Hovell Street will start from 10 March 2025 with the closure of the Campbell Street, between Sutton and Hovell Streets, as Stage 1 of the upgrade project begins.

Hovell Street has been identified as a critical thoroughfare for heavy vehicle movements within Cootamundra, and the road surface has deteriorated significantly with the increase of these movements over the years.

Notices will be issued to residents and businesses along Hovell Street as the project progresses advising of road closures, partial road closures and any disruptions to property access.

The Hovell Street upgrade project has seen a considerable amount of preliminary work undertaken with service locations such as gas, water, sewer main, and telecommunication cables identified and marked. Survey works have been ongoing to identify and map out the physical features of the street area including boundaries, elevations, contours and storm water flow.

The current road pavement consists of natural pit gravel, completed with a two-coat seal, a traditional pavement method used for urban streets. However, with the increase in vehicle traffic and type of vehicles using the street this road surface can no longer stand up to the demands placed on it by those increases.

Cootamundra-Gundagai Regional Council (CGRC), with the assistance of Geotechnical Engineers and Road Pavement Designers, CGRC have decided on a plan that will increase the design life of the road pavement from 25 years to 100 years. Using a design that consists of 470mm thick road base material and capping with a wearing course of 40mm asphalt. This design is an investment into the long-term maintenance and repair issues associated with the street and with heavy vehicle movements expected to increase and will cut costs significantly for ratepayers over the long term.

Regular road maintenance programs should be limited to repairs and maintenance of the road surface, whilst the foundation pavement stays intact.

The street will also receive new kerb and guttering to assist with the effective control of storm water and alleviate road damage.

Hovell Street Upgrade Notification number 2

Hovell Street Project Timeline Brochure Final

CGRC Media Release The Heavy Work to Commence on Hovell Street
